Rice Street Reconstruction

Ramsey County, in collaboration with the City of Saint Paul, is reconstructing Rice Street between Pennsylvania Avenue and Wheelock Parkway from 2025 to 2027. Construction will take place in three phases.

  • Phase One (Spring 2025-Fall 2025): Wheelock to the north side of Maryland Avenue.
  • ​Phase Two (Spring 2026-Fall 2026): Maryland Avenue to Sycamore Street and Pennsylvania Avenue intersection.
  • Phase Three (Spring 2027-Fall 2027): Sycamore Street to Pennsylvania Avenue.

This project is a full roadway reconstruction that will reduce the road from four lanes to three lanes with a center turn lane. The project will also add a ten-foot shared use path on the west side of Rice St.

The project will also include ADA improvements, improved transit stations, shorter pedestrian crossings at intersections, enhanced drainage and additional snow storage, and bridge rehabilitation and reconstruction.

Subscribe to Rice Street updates

Goals

  • Promote economic growth and community investment while maintaining and providing business opportunities.
  • Create an inviting environment.
  • Enhance pedestrian and bicyclist safety.
  • Maintain and augment transit service.
  • Continue to increase vehicle safety.

Visualization

Timeline​

October

  • Maryland Avenue to Cook Avenue
    • Ongoing installation of trees, planting, and restoration work
    • Street lighting and electrical installation
  • Cook Avenue to Atwater Street
    • Sidewalk, median, and pedestrian ramp grading and concrete work
    • Trail grading and paving
    • Roadway sub-cutting
    • Roadway base paving
    • Street lighting and electrical installation

November

  • Cook Avenue to Atwater Street
    • Final layer of paving
    • Signage and striping installation
    • Boulevard restoration work
    • Planting of trees and grass seeding
    • Overall corridor restoration

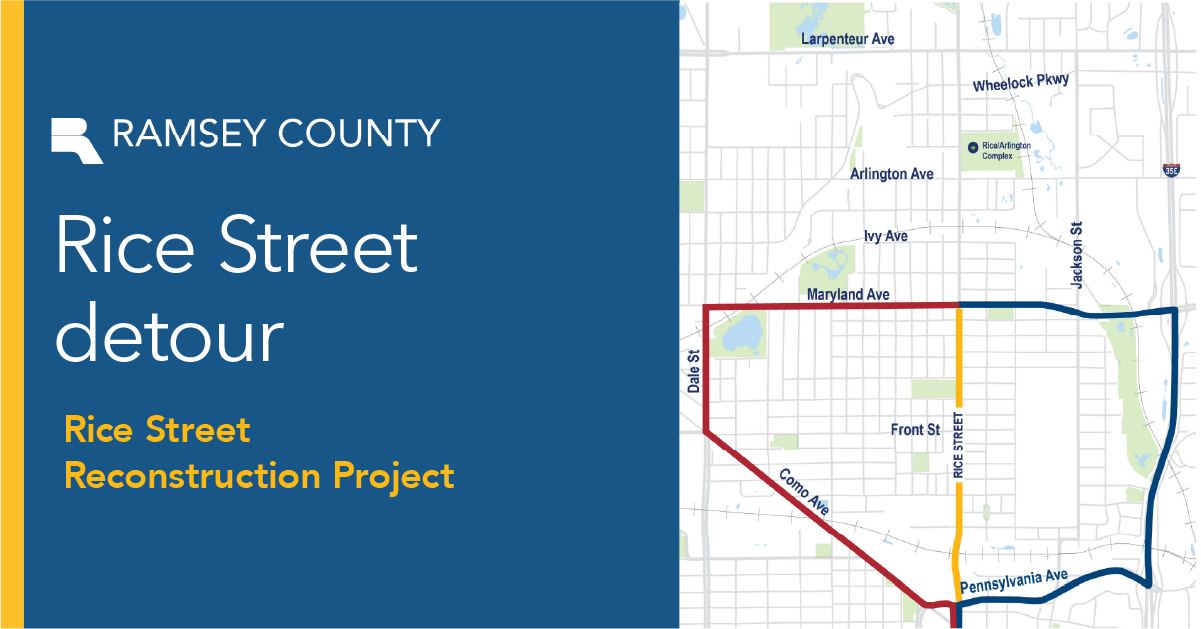

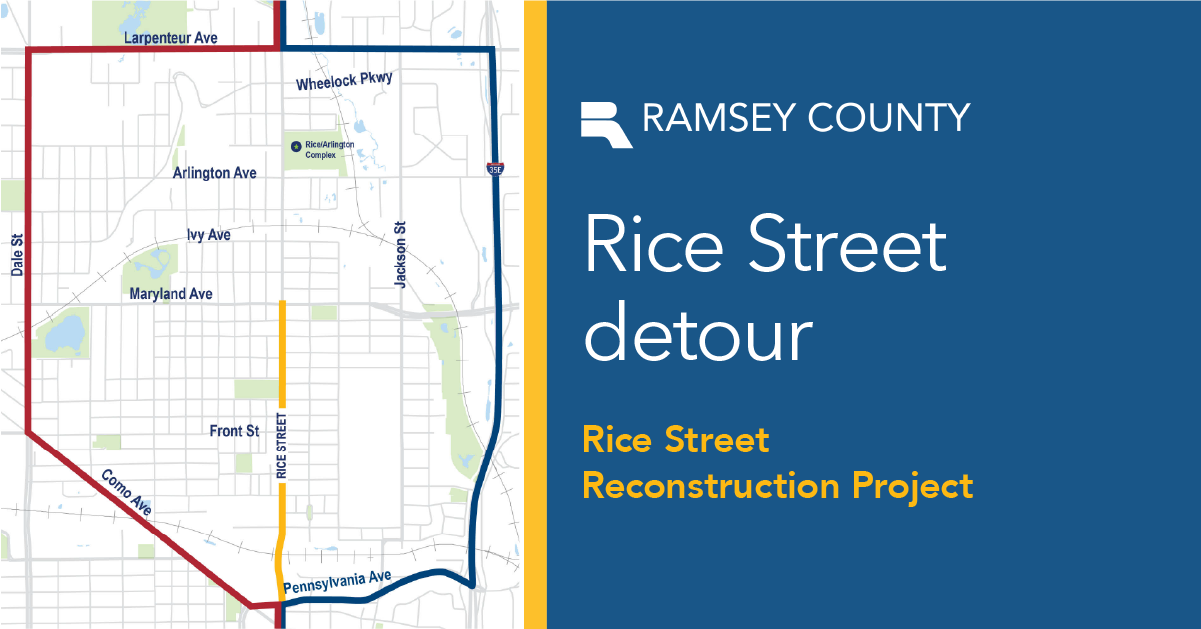

Traffic impacts

  • Rice Street from just south of Maryland Avenue to the south side of Atwater Street is closed.
  • Pedestrian access will be maintained along one side of Rice Street at all times.   
  • For the most current bus detour and rider updates please visit Metro Transit Rider Alerts.

Community engagement

Business Engagement Event

The Rice Street project team recently hosted two virtual business meetings to share information about upcoming 2026 construction activities and answer questions. Both meetings covered the same content and provided an opportunity for business owners to engage directly with the project team.

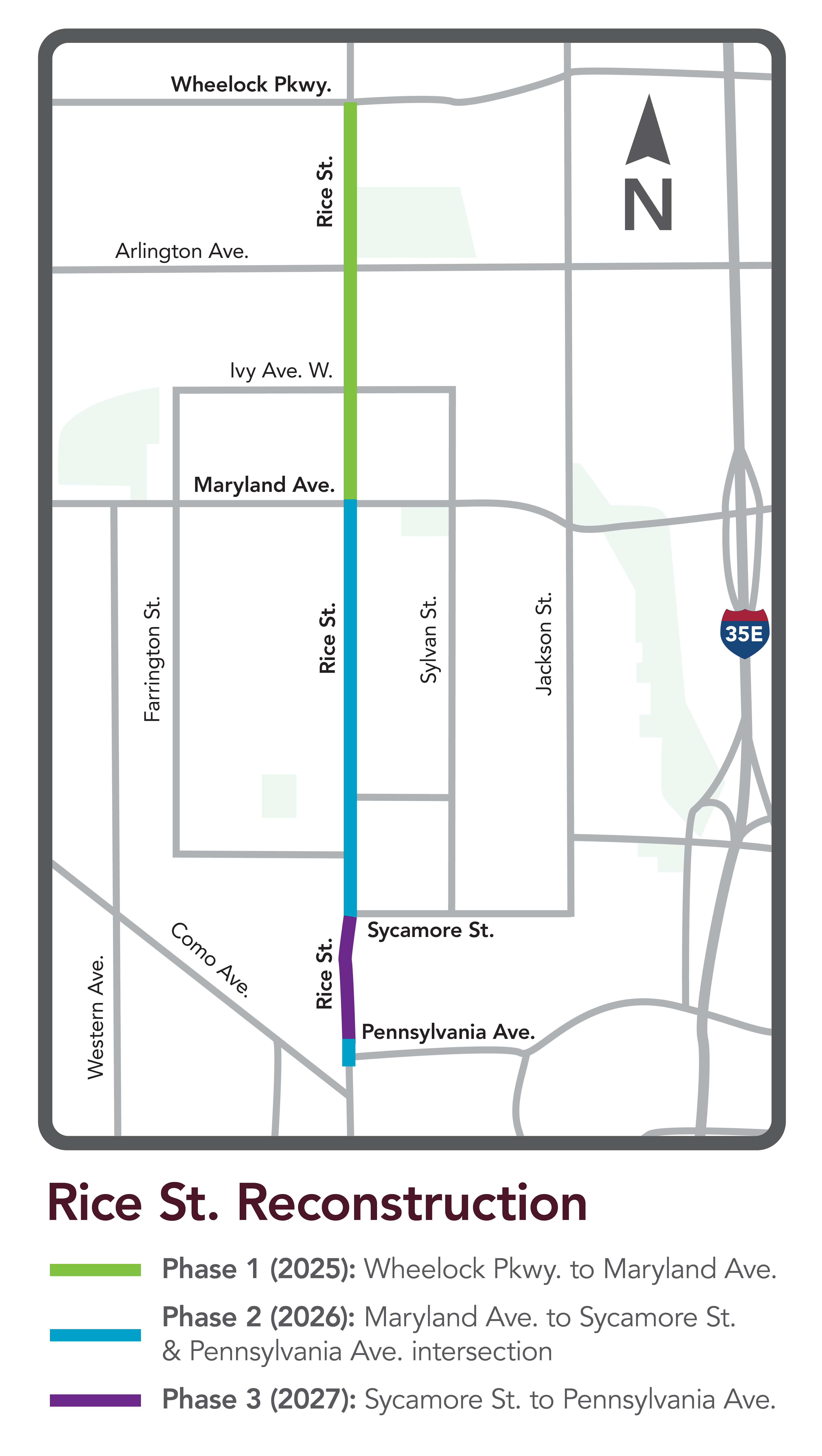

Project area

This depicts a map of Rice Street from Wheelock Parkway to Pennsylvania Avenue. There are three sections on Rice Street highlighted. Phase 1 (2025) Wheelock Parkway to Maryland Avenue. Phase 2 (2026) Maryland Avenue to Sycamore Avenue & Pennsylvania Avenue intersection. Phase 3 (2027) Sycamore Street to Pennsylvania Avenue.
